To keep costs at a minimum and decrease the completion time by 1-1/2 days, Networks, Inc.should crash activity(ies):
Answer(s): A
The critical (longest) path is A-D-E, which has an expected time of 13 days (5.5 + 7.5). However, to decrease the project's completion time by 1.5 days, paths A-B-C-E (4.5 + 1.0 + 6.5 = 12 days) and A-B-D-E (4.5 + .5 + 7.5= 12.5 days) as well as A-D-E must also be shortened. Hence, A-D-E must be reduced by 1.5 days. A-B-C-E by .5 day, and A-B-D-E by 1.0 day. The only way to decrease A-D-E by 1.5 days is to crash activity AD (5.5 expected time - 4.0 crash time = 1.5 days). Crashing DE results in a 1.0-day saving (7.5-6.5) only. Crashing AB is the efficient way to reduce both A-B-C-E and A-B-D-E by the desired amount of time because it is part of both paths. The incremental cost of crashing AB is US $1,000 (US $4,000 crash cost - US $3,000 normal cost) to shorten the completion time by 1.0 day (4.5 - 3.5). The alternatives for decreasing both A-B-C-E and A-B-D-E are more costly.
When making a cost-time trade-off in CPM analysis, the first activity that should be crashed is the activity:
Answer(s): D
When making a cost-time trade-off, the first activity to be crashed (have its completion time accelerated) is one on the critical path. To select an activity on another path would not reduce the total time of completion. The initial activity chosen should be the one with the completion time that can be accelerated at the lowest possible cost per unit of time saved.
In PERT, slack is the:
Slack is the amount of time that commencement of an activity can be delayed without forcing a delay of the entire project.

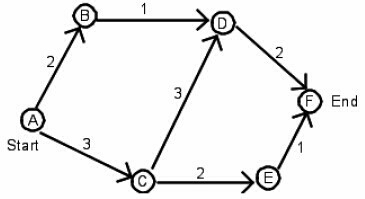

The network below describes the interrelationships of several activities necessary to complete a project. The arrows represent the activities. The numbers between the arrows indicate the number of months to complete each activity.The shortest time to complete the project is:
Answer(s): C
The critical (longest) path through the network from node (A) to node (F) is path A-C-D-F. All other paths are shorter than path A-C-D-F, so the activities along those paths can be completed before the activities along path A-C-D-F. Thus, the shortest time to complete the project is 8 months (3 + 3 + 2).
A shortest-route algorithm is used in network models to:
Answer(s): B
Network models are used to solve managerial problems pertaining to project scheduling, information systems design, and transportation systems design. Networks consisting of nodes and arcs may be created to represent in graphic form problems related to transportation, assignment, and transshipment. The shortest-route, minimal spanning tree, and maximal flow problems are other applications of network models. A shortest-route algorithm minimizes total travel time from one site to each of the other sites in a transportation system.
Share your comments for Financial CIA-III exam with other users:
i need it very much please share it in the fastest time.
correct answer is d for student.java program
q:37 c is correct
q6 exam topic: terramearth, c: correct answer: copy 1petabyte to encrypted usb device ???
explained answers
plan to take theaws certified developer - associate dva-c02 in the next few weeks
very helpfull
good questions
help to practice csa exam
nice tip and well documented
i need the exam
please upload
prepping for fsc exam
pd1 with great experience
@t it seems like azure service bus message quesues could be the best solution
helpful to check your understanding.
question 128 the answer should be static not auto
more comments here
great support to appear for exams
useful dumps
making progress
q31 answer should be d i think
is this real?
q10: c and f are also true. q11: this is outdated. you no longer need ownership on a pipe to operate it
good questions with simple explanation
admin guide (windows) respond to malicious causality chains. when the cortex xdr agent identifies a remote network connection that attempts to perform malicious activity—such as encrypting endpoint files—the agent can automatically block the ip address to close all existing communication and block new connections from this ip address to the endpoint. when cortex xdrblocks an ip address per endpoint, that address remains blocked throughout all agent profiles and policies, including any host-firewall policy rules. you can view the list of all blocked ip addresses per endpoint from the action center, as well as unblock them to re-enable communication as appropriate. this module is supported with cortex xdr agent 7.3.0 and later. select the action mode to take when the cortex xdr agent detects remote malicious causality chains: enabled (default)—terminate connection and block ip address of the remote connection. disabled—do not block remote ip addresses. to allow specific and known s
very inciting
question 5, it seems a instead of d, because: - care plan = case - patient = person account - product = product2;
it look like real one
i am taking oracle fcc certification test next two days, pls share question dumps
i need dumps
its time to comptia sec+
question 35 has an answer for a different question. i believe the answer is "a" because it shut off the firewall. "0" in registry data means that its false (aka off).
helpful content
